Custom Bag Production Lead Time in Singapore: The Complete Planning Guide

Custom Bag Production Lead Time in Singapore: The Complete Planning Guide

For Singapore businesses ordering custom bags, expect 2-4 weeks for standard orders (100-500 pieces) and 4-8 weeks for larger or highly customised orders. This timeline assumes materials are in stock and design approval proceeds smoothly. The actual duration depends on three critical factors: order quantity, customisation complexity, and your supplier's current production capacity.

Why Custom Bag Lead Time Is a Critical Decision

Understanding production timelines is not merely an operational concern—it directly impacts your budget, brand reputation, and project success. Based on our experience assisting Singapore enterprises with corporate procurement, lead time miscalculations are among the top three reasons for failed promotional campaigns.

From a budget control perspective, rushed orders typically incur 15-30% premium charges for expedited production and air freight. A project that could cost SGD 5 per unit under normal timelines might escalate to SGD 7-8 per unit when compressed into a two-week rush order.

Brand image considerations are equally important. When production is rushed, quality control steps are often shortened or skipped entirely. We have seen cases where companies received bags with misaligned logos, inconsistent stitching, or colour variations that deviated significantly from approved samples.

The Practical Procurement Process

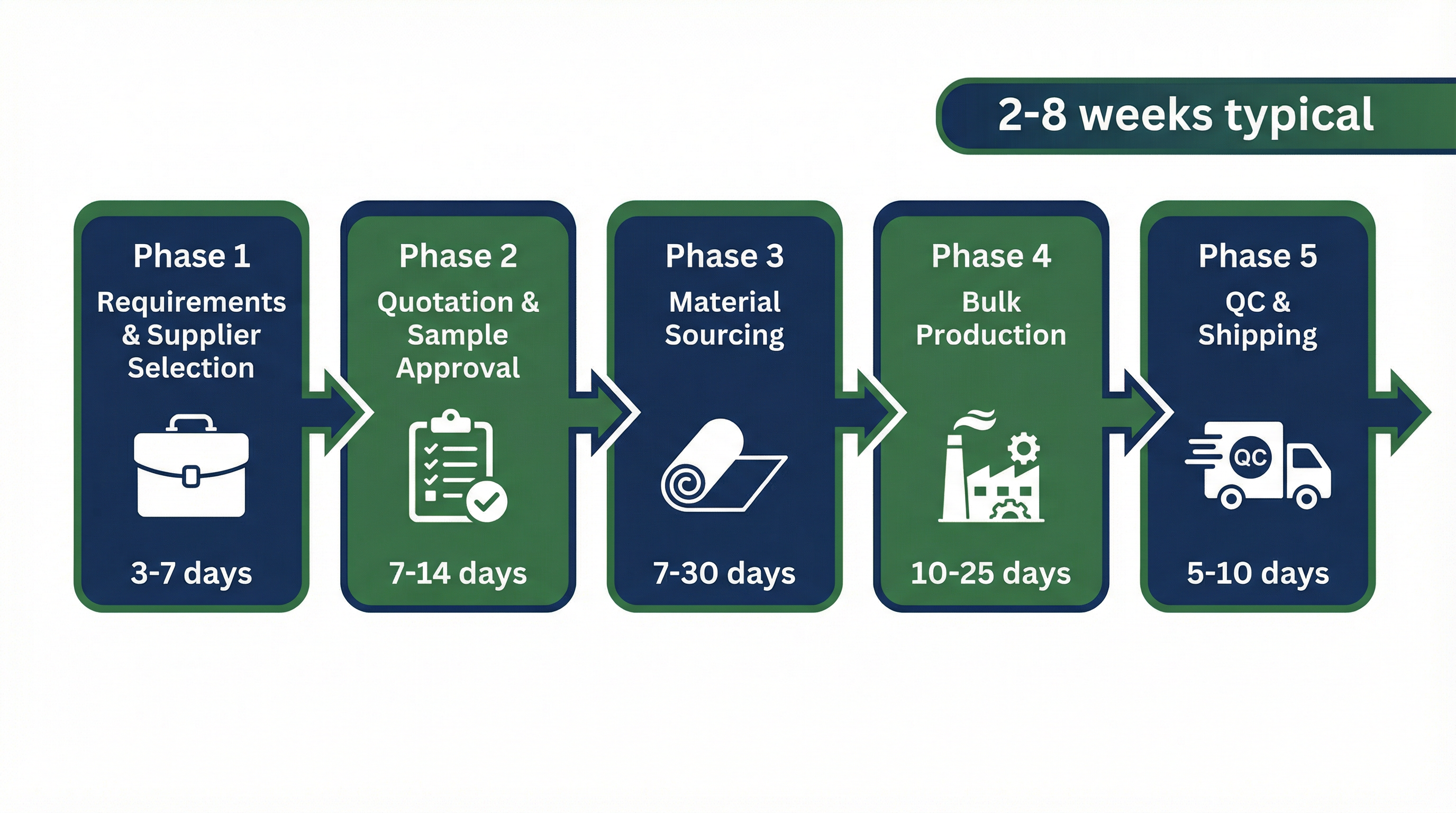

The journey from initial enquiry to final delivery involves several distinct phases:

Phase 1: Requirements Definition and Supplier Selection (3-7 Days) This initial phase involves clarifying your specifications—bag type, material, dimensions, printing method, and quantity—and identifying suitable suppliers.

Phase 2: Quotation and Sample Approval (7-14 Days) Once specifications are confirmed, suppliers provide detailed quotations. Sample approval is the most critical checkpoint in the entire process—bulk production should never commence without written approval of a physical sample.

Phase 3: Material Sourcing and Preparation (7-30 Days) Standard materials like 8oz canvas, PP non-woven, or 600D polyester are typically available within 7-10 days. However, specialised materials—organic cotton, recycled PET fabric, or custom Pantone-matched colours—can extend this phase to 30-45 days.

Phase 4: Bulk Production (10-25 Days) Actual manufacturing time depends on order quantity and bag complexity. Simple tote bags with single-colour printing can be produced at rates of 500-1,000 pieces per day.

Phase 5: Quality Control and Shipping (5-10 Days) Final inspection, packing, and delivery within Singapore typically takes 5-7 business days.

Key Factors That Determine Your Timeline

Material Selection: Standard materials enable faster production but limit differentiation, while premium or sustainable materials enhance brand positioning but require longer planning horizons.

Customisation Complexity: Screen printing takes 1-2 days, heat transfer 2-3 days, embroidery 5-10 days, and debossing/embossing 7-14 days.

Order Quantity: 100-300 pieces typically require 2-3 weeks, 300-1,000 pieces need 3-4 weeks, and 5,000+ pieces may require 6-8 weeks.

Singapore-Specific Considerations

Singapore's position as a regional logistics hub means delivery from regional manufacturing centres is typically faster than for other Southeast Asian markets. Sea freight from Southern China takes approximately 5-7 days.

For bags imported from overseas, GST at 9% applies to the CIF value. If your bags will be used for food packaging or food-adjacent purposes, materials must comply with Singapore Food Agency regulations.

Recommendations by Business Size

For Startups and SMEs: Build a relationship with one reliable supplier rather than constantly seeking the lowest quote. Established relationships often unlock priority production slots during peak seasons.

For Large Enterprises and MNCs: Planning horizons of 8-12 weeks are typical for organisations with formal procurement approval processes. Ensure factory audit documentation (BSCI, SEDEX) is in place.

Conclusion

Successful custom bag procurement in Singapore requires balancing multiple factors: timeline, budget, quality, and compliance requirements. We recommend starting the supplier engagement process at least 8 weeks before your required delivery date.
