There is a pattern that repeats itself across procurement departments with remarkable consistency. A corporate bag order is placed with a supplier who confirms a four-week production timeline. The bags are manufactured on schedule, quality inspection passes without issue, and the shipment is dispatched exactly as promised. The procurement team marks the delivery date in their calendar based on the quoted five-day sea freight transit time. Then the bags arrive three days after the corporate event they were ordered for.
The failure is not in production. The failure is in the assumption that "shipping time" means "time from factory gate to office reception." In practice, this is where lead time calculations most frequently collapse—not because logistics providers are unreliable, but because the shipping phase contains multiple sequential handoffs, each with its own timing variables that compound in ways procurement teams rarely anticipate.
The transit time quoted by a freight forwarder represents only the vessel sailing duration—the period when goods are physically moving across water. What that figure excludes is substantial. Before a container boards a vessel, it must be loaded at the factory, transported to the port, processed through export customs, and positioned in the terminal queue for loading. After the vessel arrives at destination, the container must be unloaded, cleared through import customs, released from the terminal, transported to a local warehouse or directly to the delivery address, and finally scheduled for last-mile delivery. Each of these stages operates on its own timeline, and none of them are included in the "5-7 day transit" figure that appears on shipping quotations.

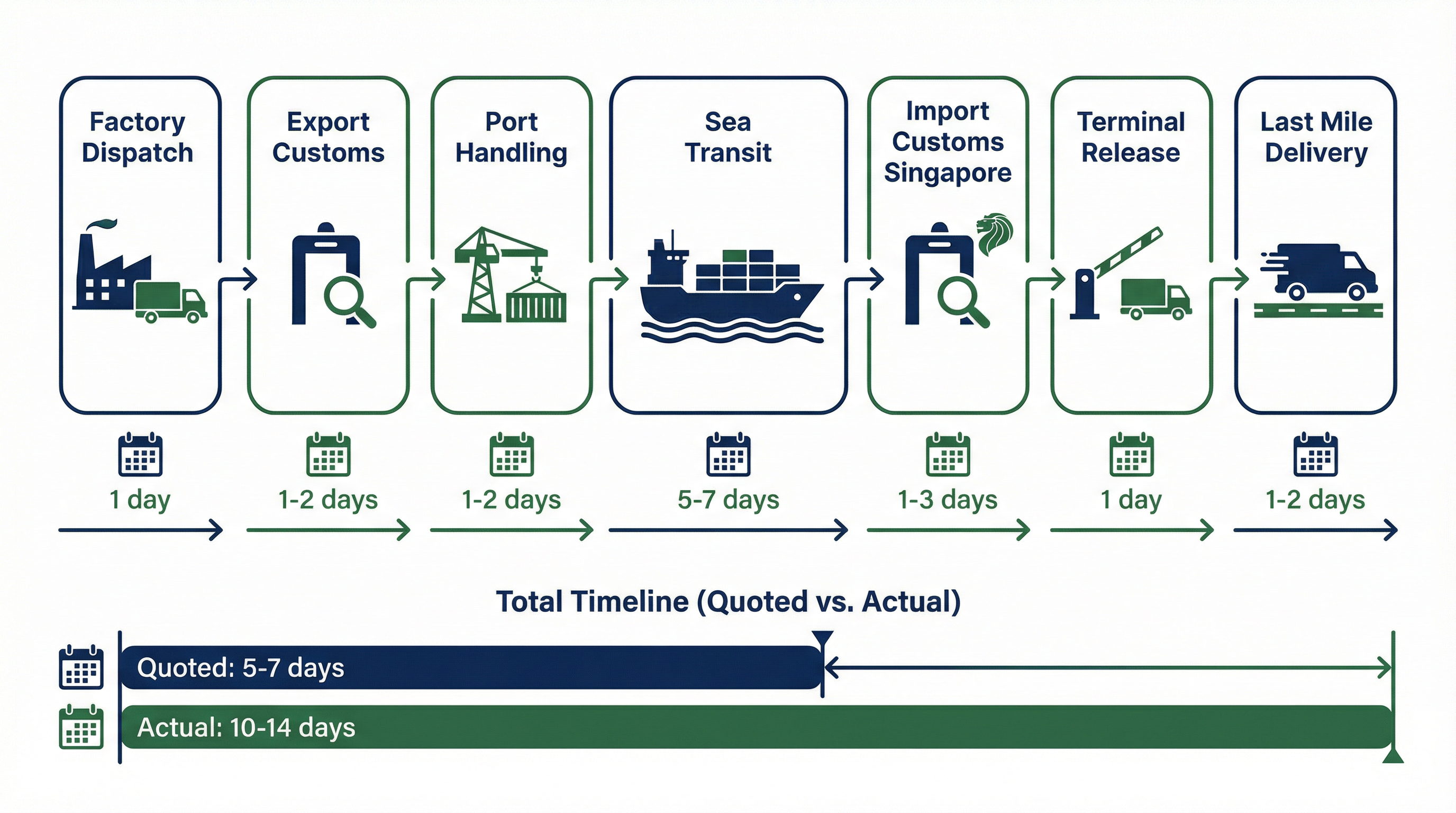

For Singapore-bound shipments from regional manufacturing centres, the practical reality is that a five-day sea freight transit typically translates to 10-14 days from factory dispatch to warehouse receipt. The additional time accumulates across predictable friction points. Export customs clearance in the origin country requires 1-2 business days. Port handling and vessel loading adds another 1-2 days. At the Singapore end, import customs processing—including GST assessment at the current 9% rate—requires 1-3 business days depending on documentation completeness. Terminal release and container unstuffing adds another day. Final delivery scheduling, particularly to industrial areas with restricted access hours, can add 1-2 more days.
The compounding effect becomes more severe during specific calendar periods. The weeks preceding Chinese New Year see regional ports operating at capacity, with vessel space at premium and customs processing backlogs extending normal clearance times by 50-100%. Similar patterns emerge before Hari Raya Puasa and the December holiday season. These are not unpredictable events—they occur on fixed dates every year—yet procurement timelines routinely fail to account for their impact on logistics throughput.
There is a secondary factor that affects Singapore specifically. The efficiency of PSA terminals means that under normal conditions, container dwell time is minimal. However, this efficiency creates an expectation baseline that becomes problematic when any deviation occurs. A single documentation error—an incorrect HS code, a missing certificate of origin, a discrepancy between commercial invoice and packing list—can trigger a customs query that adds 3-5 business days to clearance time. For corporate bags containing mixed materials or those claiming preferential duty treatment under trade agreements, the documentation requirements are more complex and the error probability correspondingly higher.
The practical implication for planning corporate bag delivery timelines is that the shipping phase should be treated as a variable range rather than a fixed value. A conservative approach adds 50% buffer to quoted transit times for standard shipments and 100% buffer for shipments scheduled to arrive within two weeks of major holidays. This buffer is not pessimism—it is acknowledgment that the logistics chain contains multiple independent variables, any one of which can extend the timeline without warning.
The most reliable mitigation is not faster shipping but earlier ordering. Air freight can compress transit time to 2-3 days, but it does not eliminate customs processing, terminal handling, or last-mile delivery scheduling. It simply shifts the cost structure while leaving the fundamental timing uncertainties intact. The procurement teams that consistently receive orders on time are not those with the best freight forwarders—they are those who build sufficient buffer into their timelines to absorb the inevitable variability that logistics operations entail.
