From the factory side, we can usually tell how late a corporate gift bag order was placed by how narrow the brief is. Not narrow in the sense of being precise—narrow in the sense of having no room left. The client does not want a specific bag. They want whatever bag can be delivered in the time remaining. This is the pattern behind most underwhelming corporate gift bag programmes in Singapore, and it has nothing to do with budget, taste, or supplier quality. It has to do with when in the event planning cycle the gift bag decision gets made.
The typical sequence runs like this. An event is confirmed eight to twelve weeks out. The first four to six weeks are consumed by venue logistics, speaker coordination, catering, AV setup, attendee registration systems, and internal approvals. The gift bag—if it appears on the planning document at all—sits somewhere near the bottom, grouped with items like name badges, lanyards, and signage. It is categorised as a procurement task rather than a strategic one. Around three to four weeks before the event, someone remembers the bags. A brief is drafted quickly, usually by pulling specifications from the previous order or by browsing a supplier catalogue for thirty minutes. The order is placed with whatever can be confirmed within the remaining window.

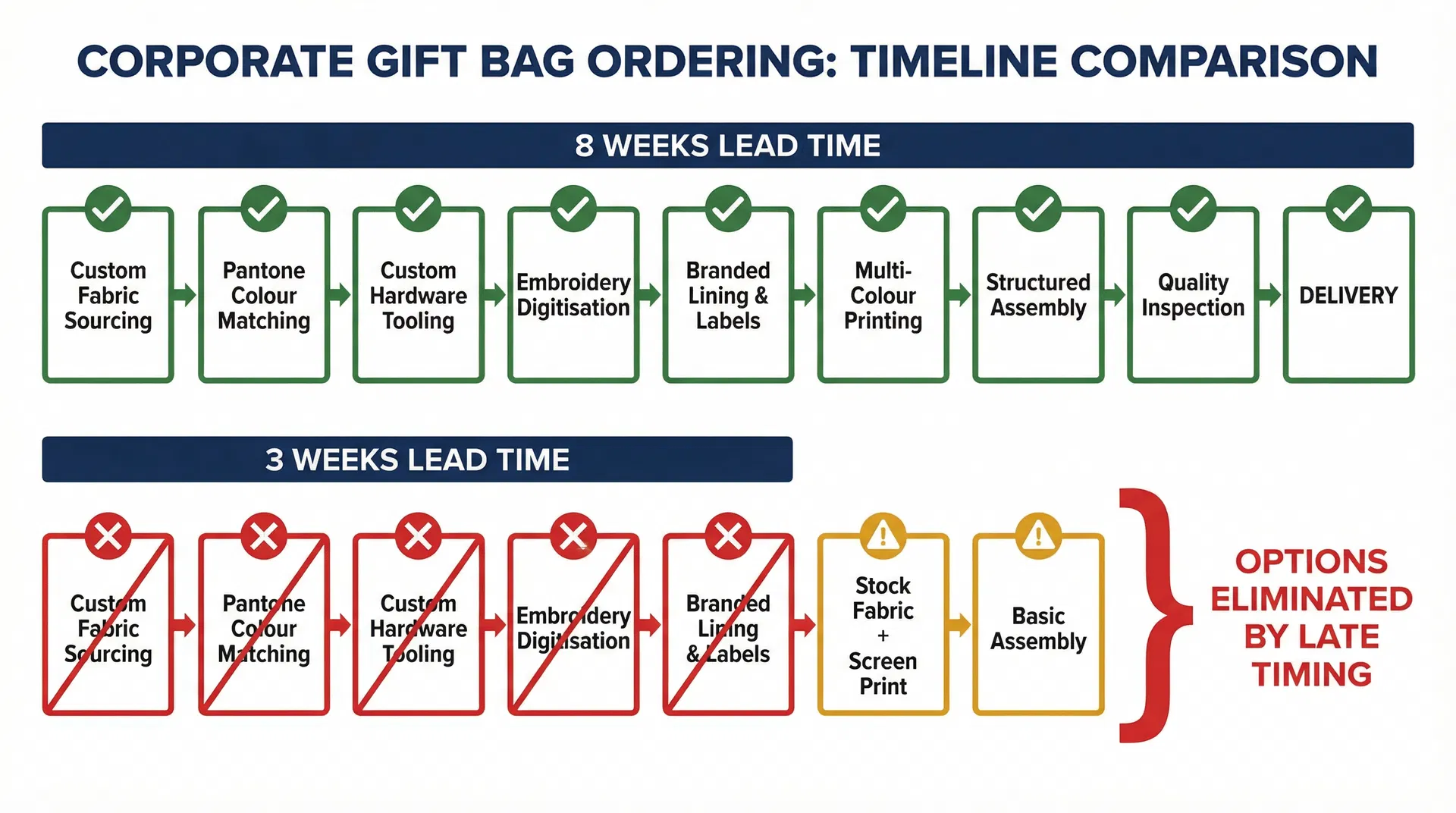

What the event team does not see is what that compressed timeline does to the available options on the production side. A corporate bag with custom specifications—specific fabric weight, Pantone-matched colour, custom hardware, branded lining, structured base—requires a production sequence that begins with material sourcing. The fabric itself, if it is not a stock option, takes ten to fifteen working days to weave or dye to specification. Hardware components like custom zip pulls or magnetic closures require separate tooling. Printing setups for multi-colour screen printing or heat transfer need artwork preparation, plate making, and colour proofing. Each of these steps has its own minimum lead time, and they do not run in parallel—they sequence.
When the order arrives at three weeks, the factory does not refuse it. Factories in this region are accustomed to tight timelines and will accommodate rush orders. But accommodation means substitution. The custom 12-ounce canvas in the client's brand colour becomes a stock 8-ounce canvas in the closest available shade. The embroidered logo becomes a screen-printed logo because embroidery requires digitisation and stitch sampling that cannot be compressed below five working days. The reinforced base panel is dropped because the base board supplier cannot deliver in time. The internal pocket with a branded label is simplified to a plain pocket because woven labels have their own three-week production cycle.
Each substitution is individually reasonable. The factory communicates each change, the client approves each one because there is no alternative, and the final product ships on time. But the bag that arrives is not the bag that would have been ordered if the decision had been made eight weeks earlier. It is a bag shaped entirely by what was still possible within the remaining window. The client evaluates the bag against their expectations and finds it adequate but unremarkable. They conclude that the supplier's quality is average, when in reality the supplier's options were average because the timeline made them so.
This dynamic creates a self-reinforcing cycle that is worth understanding. Because the previous gift bag was unremarkable, the next event's planning team assigns even less priority to the bag decision. If the last bag was forgettable, why invest more planning time in the next one? The bag stays at the bottom of the checklist. The order is placed late again. The factory makes the same substitutions. The bag is again adequate but unremarkable. Over multiple event cycles, the organisation develops a settled belief that corporate gift bags are inherently generic items—commodities where supplier selection barely matters. This belief is not wrong given their experience. It is wrong given what would have been possible with a different timeline.
The cost implications extend beyond the bag itself. Rush production does not just limit options—it restructures the pricing. A factory running a three-week turnaround on a job that normally takes six weeks is pulling that job ahead of other scheduled orders. This requires overtime labour, expedited material procurement at premium rates, and sometimes air freight for components that would normally ship by sea. The rush surcharge—typically fifteen to thirty percent above standard pricing—is visible on the invoice. What is not visible is the option cost: the client is paying more for a lesser bag. The per-unit cost of the rush order often exceeds what a superior bag would have cost at standard lead time.
There is a specific version of this problem that recurs with conference and event bags in Singapore. The event organiser specifies a bag that needs to hold an A4 folder, a water bottle, a lanyard, and assorted collateral. At eight weeks, this brief could produce a structured canvas tote with a padded laptop compartment, reinforced handles, a zippered top, and subtle branding—a bag that attendees would carry to work for months after the conference. At three weeks, the same brief produces a flat non-woven bag with a single compartment and a one-colour logo. Both bags technically meet the functional specification. Both hold an A4 folder and a water bottle. But one becomes part of the attendee's daily routine, and the other goes into the recycling bin at the hotel lobby before the attendee reaches the taxi queue.
The decision about which types of corporate gifts best serve different business needs is often framed as a question of budget or taste, but from the production side, it is primarily a question of timing. A modest budget with adequate lead time produces a better outcome than a generous budget with inadequate lead time. The factory can optimise for quality, for cost, or for speed—but only two of those three simultaneously. When speed is the binding constraint, either quality or cost must give way, and in practice both do. The client pays rush pricing for a bag that has been stripped of the features that would have made it worth keeping.
The structural fix is straightforward but requires a shift in how event planning teams categorise the gift bag. It is not a procurement item to be ordered alongside name badges and lanyards. It is a brand asset that requires the same lead time consideration as printed collateral or stage design. When the gift bag brief is drafted in the first two weeks of event planning—alongside venue selection and speaker invitations—the full range of customisation options remains available. The factory can source specific materials, produce accurate colour matches, execute complex printing techniques, and include structural features that transform a bag from a disposable container into something recipients actually want. A structured approach to selecting gift bags for specific business contexts only works when the timeline allows the selected option to actually be produced.
The most revealing question to ask about any corporate gift bag programme is not what was the budget, but when was the decision made. If the answer is less than four weeks before the event, the bag was not chosen. It was whatever remained after the timeline eliminated everything else.
