Why Every Premium Finishing Detail on a Corporate Bag Adds a Separate Supply Chain You Did Not Plan For

Why Every Premium Finishing Detail on a Corporate Bag Adds a Separate Supply Chain You Did Not Plan For

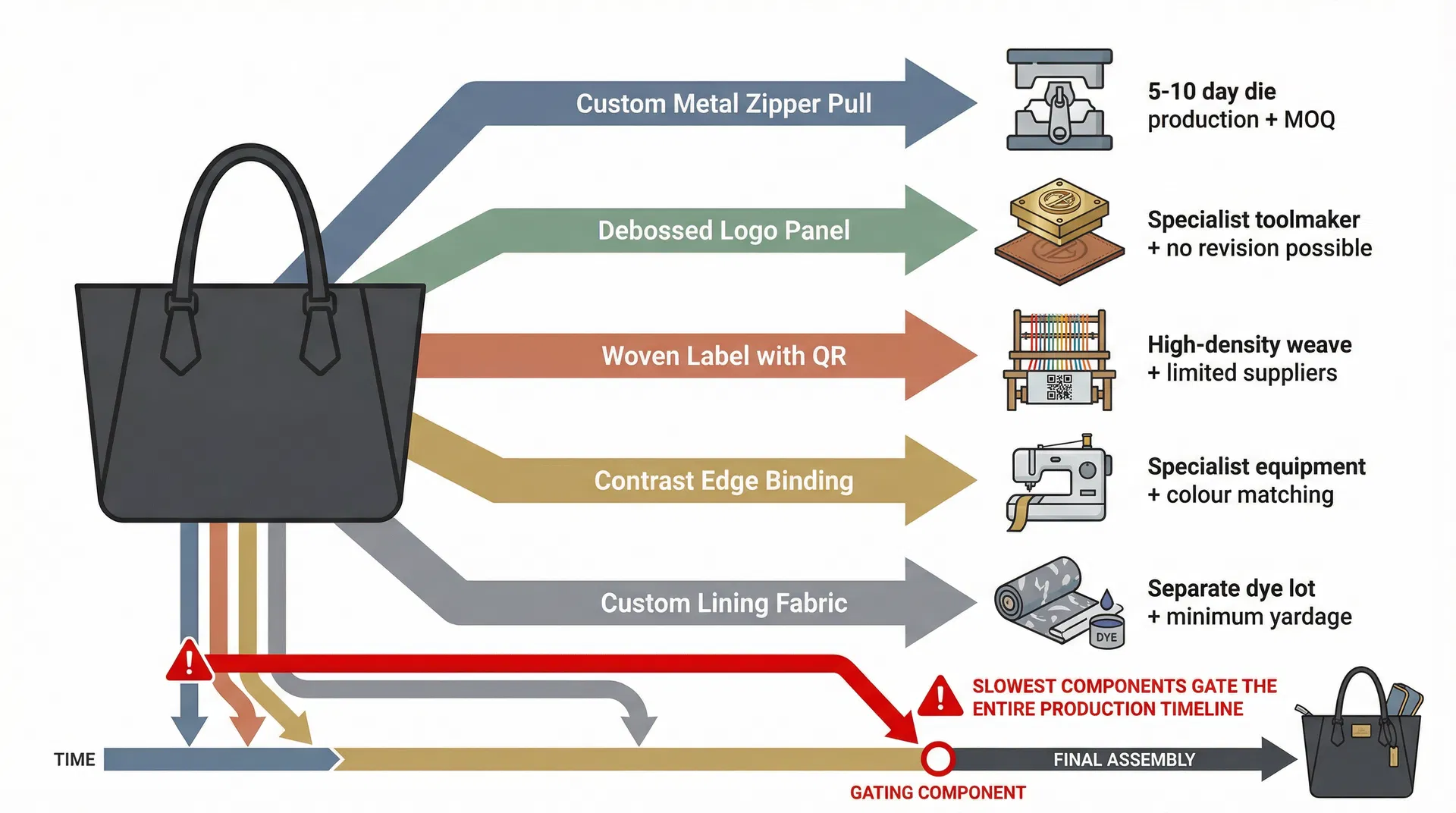

The request usually sounds simple. A procurement manager reviewing a corporate bag sample will point to the zipper pull and ask whether it can be replaced with a custom metal one carrying the company logo. Or they will suggest adding a debossed monogram to the front panel, or replacing the standard woven label with one that includes a QR code. Each of these requests, taken individually, seems minor. A small upgrade. A finishing touch. From the production planning side, each one represents an entirely separate supply chain that now needs to be coordinated with the main bag production timeline, and the cumulative effect of three or four such requests on a single bag design is where customisation projects begin to unravel in ways that nobody anticipated at the briefing stage.

The reason this happens is structural, not incidental. A corporate bag in its base form is assembled from components that the factory either produces in-house or sources from a small number of established suppliers with predictable lead times. The fabric is cut and sewn on the factory floor. The printing is done in-house or by a closely integrated partner. The standard hardware—generic zipper pulls, D-rings, snap buttons—comes from stock that the factory maintains in bulk. The production schedule for a standard customised bag can be planned with reasonable confidence because the supply chain is short and familiar.

The moment a premium finishing detail is introduced, a new supply chain branch is created. A custom metal zipper pull, for example, does not come from the same supplier that provides the factory's standard zipper stock. It requires a separate order to a metal casting or stamping supplier, who needs the logo artwork in a format suitable for die production. The die itself takes five to ten working days to produce, depending on complexity. Once the die is ready, a sample pull is cast and sent for approval. After approval, the production run for the pulls begins—and metal component suppliers typically have their own minimum order quantities, which may be significantly higher than the number of bags being produced. The factory now holds surplus custom zipper pulls that have no use beyond this specific order, and the cost of that surplus is either absorbed into the unit price or charged separately as a tooling fee that appears on the invoice without much explanation.

Debossing and embossing follow a similar pattern. A debossed logo on a leather or faux-leather panel requires a brass or steel die that is manufactured to the exact dimensions and depth specified by the artwork. Die production is outsourced to a specialist toolmaker, not handled by the bag factory. The die has its own lead time, its own approval cycle, and its own cost structure. If the artwork is revised after the die has been cut—which happens more often than anyone would like to admit—a new die must be produced from scratch. There is no way to modify an existing embossing die. The original die becomes scrap, and the cost and time invested in it are lost entirely.

Woven labels present a deceptively complex challenge. A standard woven label with the company name and a simple logo can be produced by most label suppliers within seven to ten days. But when the specification calls for a high-density weave with fine text, metallic thread, or a fold-over design with printed care instructions on the reverse, the label moves into a category that fewer suppliers handle, with longer lead times and higher minimum quantities. A label that includes a QR code adds another layer of complexity: the weave density must be high enough to produce a scannable code, which limits the supplier pool further and increases the per-unit cost substantially. The label, which the client may think of as a minor detail, can become the component with the longest lead time in the entire production schedule.

Edge binding and piping are finishing techniques that affect not just the supply chain but the production line itself. Not all sewing machines can handle binding tape application, and not all operators are trained in the technique. If the bag design calls for contrast-colour binding along the top edge or around the zipper panel, the factory may need to allocate the work to a specific machine and operator, creating a bottleneck in the production flow. If the binding tape is a custom colour that must match the client's brand palette, it becomes another component that needs to be sourced, colour-matched, and approved before production can begin.

What makes this particularly difficult to manage is that these finishing details are almost always decided late in the customisation process. The initial briefing focuses on the bag's basic parameters: size, material, colour, print design. The finishing details emerge during sample review, when the physical prototype makes it possible to visualise what the final product could look like with a few enhancements. By this point, the production timeline has already been set based on the original specification. Each finishing detail that is added after the timeline is established does not simply add its own lead time to the schedule—it creates a dependency that the entire production must wait for. The bags cannot be fully assembled until the custom zipper pulls arrive. The panels cannot be sewn until the debossing is complete. The labels cannot be attached until they are delivered and inspected. The production line, which was planned as a continuous flow, becomes a series of waiting points gated by the slowest finishing component.

In practice, this is often where customisation process decisions start to be misjudged. The procurement team sees each finishing detail as a small addition to an existing order. The factory sees each one as a separate project with its own supplier, its own timeline, its own quality control requirements, and its own potential for delay. The gap between these two perspectives is where timelines slip, costs escalate, and the final product arrives later and more expensive than anyone expected. The finishing details that were meant to elevate the bag's perceived quality end up being the elements that compromise the project's delivery reliability.

The practical implication, which connects to the broader sequence of decisions in a customisation project, is that finishing details should not be treated as afterthoughts that can be layered onto a design at any stage. They need to be identified and specified at the same time as the base bag design, so that their supply chains can be initiated in parallel rather than in sequence. A custom zipper pull ordered at the same time as the fabric has a reasonable chance of arriving before assembly begins. The same pull ordered three weeks into the production schedule will almost certainly delay the entire project. The distinction is not about the pull itself—it is about when the decision to include it was made, and whether the production plan accounted for it from the start.
